I-64 / I-295 Interchange Modification Project |
The western I-64/I-295 interchange, near Short Pump in western Henrico County, Virginia, has a $49.1 million construction project underway to provide a 2-lane semi-directional flyover ramp for the movement from eastbound I-64 to eastbound I-295 (the current movement is a one-lane loop which will be removed), and to relocate and widen to 2 lanes the ramp for the movement from westbound I-295 to westbound I-64. I-64 to the east and west of I-295 will be widened, and a section of VA-271 Pouncey Tract Road will be widened. The prime construction contractor is English Construction Co., Inc., of Lynchburg, Virginia. The owner and administrator of the respective highways, and this project, is the Virginia Department of Transportation (VDOT).
Click to go to LATEST INFORMATION UPDATE.
Interchange Modification Project
"Transportation
Board Approves One Central Virginia Contract Valued at $49 Million", VDOT
news release on March 16, 2006. Excerpt follows (in blue text):
The Commonwealth Transportation
Board (CTB) approved one contract today worth $49 million for Central Virginia
maintenance and construction projects. English Construction Company, Inc of Lynchburg,
Virginia was awarded a $49 million contract to improve the I-295/I-64 interchange
in western Henrico County, widen Pouncey Tract Road and construct a new flyover
ramp from I-64 east to I-295 north. The flyover bridge and additional lanes will
improve the flow of traffic between I-295 and Route 288. It will also improve
the traffic along Pouncey Tract Road between Broad Street and Twin Hickory Lake
Drive. Construction will begin in May 2006 and the anticipated completion date
is spring 2009.
There were
four bids received on this project. (source - VDOT):
Bids opened February 22, 2006
State Project Number 0064-043-125,C501,B689,B691
Contractor | Bid Amount |
English Construction Co., Inc. | $49,075,223.40 |
R. R. Dawson Bridge Company, LLC | $49,628,026.65 |
Vecellio & Grogan, Inc. | $56,066,153.15 |
Tidewater Skanska, Inc. | $57,474,301.80 |
The lowest bid is close to the VDOT Six Year Program budgeted figure for Construction, which is the contract award amount plus 10% for contingencies (budgeted additions and increases during the life of the contract), plus 5% for construction engineering and project management. The contract has a deadline completion date of May 22, 2009.
A 2-lane semi-directional flyover ramp will
be built for the movement from I-64 eastbound to I-295 eastbound, and the bridge
will be 1,765 feet long and will pass 35 feet above I-64; and the existing loop
ramp for that movement will be removed. The existing one-lane ramp for the movement
from I-295 westbound to I-64 westbound, will be rebuilt to a higher-speed 2-lane
ramp. These ramps will be adequately drivable at 60 mph (the design speeds are
a bit higher than that).
I-64 will be widened one lane each way to the west of I-295 for 2.0 miles, seamlessly
tying into the 0.7-mile-long 3-lane-each-way section of I-64 just east of VA-288,
and the result will be 3 lanes each way on the 2.7 miles of I-64 between VA-288
and I-295, with high-capacity freeway-standard interchange movements connecting
the freeways on the Richmond beltway route between VA-288, I-64 and I-295.
Auxiliary lanes (one each way) will be added on I-64 between I-295 and US-250
at Short Pump, and the result will be 4 lanes each way on the 0.8 miles of I-64
between I-295 and US-250. The 9 miles of I-64 between US-250 at Short Pump and
I-95 in Richmond, is currently 6 lanes (3 each way).
The 2-lane VA-271 Pouncey Tract Road overpass of I-64 will be replaced with a
longer 4-lane overpass to cross I-64 and the extended ramps to/from I-295, and
over 1/2 mile of the 2-lane VA-271 will be rebuilt to 4-lanes divided. Pouncey
Tract Road does not and will not have an interchange with I-64, but this is a
valuable traffic improvement for local traffic in the Short Pump area, as in conjunction
with a pre-existing section of 4-lane roadway, it will provide a continuous VA-271
4-lane divided thoroughfare between US-250 Broad Street Road and 1/4 mile north
of I-64, tapering to 2 lanes north of there.
The loop ramp movement from I-295 westbound to I-64 eastbound will be substantially improved by this project, as the removal of the second loop will eliminate the weaving contention between the two loops, and the entry point from the remaining loop will have an auxiliary lane constructed so that it will extend for a mile to the US-250 interchange at Short Pump.
The distance between the interchanges on I-64 in this area are, respectively, 1.2 miles between VA-623 and VA-288, 2.7 miles between VA-288 and I-295, and 0.8 miles between I-295 and US-250.
Terraserver image taken in 1994 -
I-64/I-295 Area
Advertisment date - December 27, 2005
Order Number -- G98
UPC -- 50122
Let Date -- 02/22/2006
Route Number -- 64
State Project Number -- 0064-043-125,C501,B689,B691
Federal Project Number -- IM/NH-064-3(452)
Project Length -- 5.209 Km.
Project Type -- Grade, Drain, Asp. Conc. Pave., Sound Barrier Wall, Ret. Wall,
Signals, Util., Br. (2) & Incid.
Construction Begin Site -- 3.139 Km. W. I-295 SBL
Construction End Site -- 2.070 Km. E. I-295 SBL
Showing Date -- 02/01/2006
Showing Site -- Richmond District Auditorium 02-01-06 10 am
Expiration Date -- 05/22/2009
VDOT Six Year Program entry:
UPC -- 50122
Project -- Rte 64 - I-64/I-295 Interchange Modification (W of Richmond)
Description -- From: 3.1393 Kilometers West of I-295 SBL
To: 2.0699 Kilometers East of I-295 SBL
Fund Source -- IM/NH
Program/System -- Interstate
Length -- 5.2092 KM
Route -- 0064
Estimated Cost (Thousands)
Prelim. Eng. (PE) ----- $4,759
Right-of-Way (RW) ------ $957
Construction (CN) -- $54,350
Total Estimate ------ $60,066
VDOT project website:
I-64/I-295 Flyover Bridge, Western Henrico County
Construction project website, with maps and
details of the project:
I-295 Flyover Project
The
VDOT Dashboard entry on October
29, 2008, for project
Rte 64 - I-64/I-295 Interchange Modification (West of Richmond),
state project 0064-043-125,C501,B689,B691
had the following data points:
Construction Company - English Construction Company, Inc.
Contract Execution Date -- March 27, 2006
Original Specified Completion Date -- May 22, 2009
Current Specified Completion Date -- May 22, 2009
Current Estimated Completion Date -- May 22, 2009
% Work Completed -- 83%
% Original Time Spent -- 82%
Days Charged To Date -- 933
Original # Days Allowed -- 1138
Budgeted Contract Award Amount -- $49,075,223
Cost of Work To Date -- $43,355,264
Current Contract Amount -- $50,516,640
Project < 3% Over Original Contract Award Amount
Today <= Projected Completion Date, and Projected Completion Date <= Original
Completion Date
The VDOT Dashboard
entry on November 30, 2007, for project
Rte 64 - I-64/I-295 Interchange Modification (W of Richmond),
state project 0064-043-125,C501,B689,B691
had the following data points:
Construction Company - English Construction Company, Inc.
Contractor's Notice to Proceed -- April 11, 2006
Original Specified Completion Date -- May 22, 2009
Current Specified Completion Date -- May 22, 2009
Current Estimated Completion Date -- May 22, 2009
% Work Completed -- 52%
% Original Time Spent -- 53%
Days Charged To Date -- 599
Original # Days Allowed -- 1138
Contract Award Amount -- $49,075,223
Cost of Work To Date -- $26,079,607
Current Contract Amount -- $50,219,731
Inspector's Estimated Amount to Complete -- $50,000,000
Project < 3% Over Original Contract Award Amount
Today <= Projected Completion Date, and Projected Completion Date <= Original
Completion Date
The VDOT Dashboard entry on October 8, 2007, for project
Rte 64 - I-64/I-295 Interchange Modification (W of Richmond),
state project 0064-043-125,C501,B689,B691
had the following data points:
Construction Company - English Construction Company, Inc.
Contractor's Notice to Proceed -- April 11, 2006
Original Specified Completion Date -- May 22, 2009
Current Specified Completion Date -- May 22, 2009
Current Estimated Completion Date -- May 22, 2009
% Work Completed -- 38%
% Original Time Spent -- 48%
Days Charged To Date -- 546
Original # Days Allowed -- 1138
Contract Award Amount -- $49,075,223
Cost of Work To Date -- $19,306,707
Current Contract Amount -- $50,219,731
Inspector's Estimated Amount to Complete -- $50,000,000
Project < 3% Over Original Contract Award Amount
Today <= Projected Completion Date and Projected Completion Date <= Original Completion
Date
The VDOT Dashboard entry on February 4, 2007, for project
Rte 64 - I-64/I-295 Interchange Modification (W of Richmond),
state project 0064-043-125,C501,B689,B691
had the following data points:
**LATEST INFORMATION UPDATE follows**

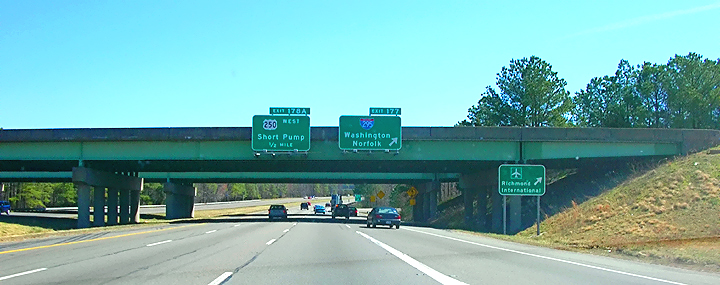

On January 12, 2009, the third lane on I-64 eastbound (toward Richmond) opened to traffic, from VA-288 to I-295, along with the 2-lane semi-directional flyover ramp for the movement from eastbound I-64 to eastbound I-295 (toward Washington and Norfolk). One lane of the ramp opened to traffic initially, and one lane remains closed as of the February 13th update of this website article, as work is still underway on a pier of the bridge.
I-295 Flyover Ramp to Open Tonight, VDOT news release, Jan. 12, 2009. Excerpt
(blue text):
Drivers along I-64 east in
western Henrico County will soon enjoy faster and safer access to I-295 thanks
to a new, two-lane flyover ramp and extra travel lane between Route 288 and I-295.
The Virginia Department of Transportation (VDOT) expects to open one lane of the
new flyover bridge to traffic by 8 p.m. The third travel lane along I-64 east
will also open.
Photos of Interchange Modification Project
These website articles for this project, track the construction with approximately monthly photo updates.
I-64/I-295 Interchange Mod. Project Photos - February 2007 - 33 photos
I-64/I-295 Interchange Mod. Project Photos - May 2007 - 7 photos
I-64/I-295 Interchange Mod. Project Photos - July 2007 - 18 photos
I-64/I-295 Interchange Mod. Project Photos - August 2007 - 18 photos
I-64/I-295 Interchange Mod. Project Photos - September 2007 - 31 photos
I-64/I-295 Interchange Mod. Project Photos - October 2007 - 38 photos
I-64/I-295 Interchange Mod. Project Photos - November 2007 - 54 photos
I-64/I-295 Interchange Mod. Project Photos -
January 2008 - 16 photos
(**New 2-9-2009**)
I-64/I-295 Interchange Mod. Project Photos -
February 2008 - 45 photos
(**Updated 2-13-2009**)
I-64/I-295 Interchange Mod. Project Photos -
March 2008 - 23 photos
(**New 1-9-2009**)
I-64/I-295 Interchange Mod. Project Photos -
April 2008 - 11 photos
(**New 12-16-2008**)
I-64/I-295 Interchange Mod. Project Photos -
May 2008 - 20 photos
(**New 12-11-2008**)
I-64/I-295 Interchange
Mod. Project Photos - June 2008 - 23 photos
(**Updated 12-3-2008**)
I-64/I-295 Interchange Mod. Project Photos -
July 2008 - 25 photos
(**New 11-19-2008**)
I-64/I-295 Interchange Mod. Project Photos -
September 2008 - 21 photos
(**New 11-13-2008**)
I-64/I-295 Interchange Mod. Project Photos -
October 2008 - 21 photos
(**New 11-2-2008**)
I-64/I-295 Interchange Mod. Project Photos -
January 2009 - 45 photos
(**Updated 1-28-2009**)
I-64/I-295 Interchange Mod. Project Photos -
February 2009 - 22 photos
(**New 4-28-2009**)
I-64/I-295 Interchange Mod. Project Photos -
April 2009 - 25 photos
(**New 5-1-2009**)
.

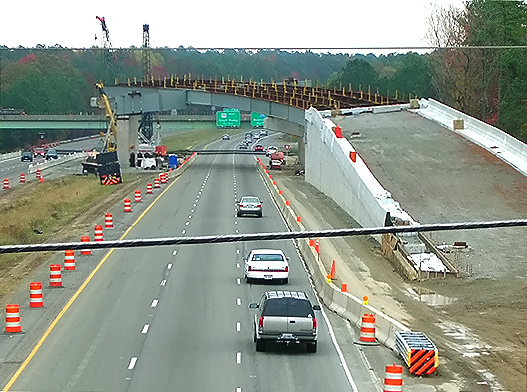

Steel
beam placement has begun for the 2-lane flyover bridge from eastbound I-64
to eastbound I-295 (toward Washington and Norfolk). The I-64 eastbound roadway
is visible to the left, and the completed construction of the piers for the
flyover bridge, and the completed construction of the Mechanically Stabilized
Earth (MSE) retaining walls on the earthen fill approach to the flyover bridge.
Vantage point is from the I-295 overpass over I-64. In the distance is the
VA-271 Pouncey Tract Road overpass, and the construction of the new Pouncey
Tract Road overpass.
Photo taken on September 29, 2007 by Roads to the Future. Click photo for large image. |
|
Steel
beam placement has begun for the 2-lane flyover bridge from eastbound I-64
to eastbound I-295 (toward Washington and Norfolk). Similar vantage point
as previous photo. Photo taken on October 20, 2007 by Roads to the Future. Click photo for large image. |
|
I-64 looking
eastward, from the VA-271 Pouncey Tract Road overpass. Two new lanes are being
constructed on the right, for the elevated approach roadway to the eastbound
flyover ramp from I-64 to I-295 (toward Washington and Norfolk). Notice the
Mechanically Stabilized
Earth (MSE) retaining walls constructed on the earthen fill approach to
the flyover bridge. Notice the flyover bridge piers that have been constructed,
and the steel girders that have been placed on several of the spans, and the
I-295 overpasses in the distance.
Photo taken on November 10, 2007 by Roads to the Future. Click photo for large image. |
Background of
I-64, I-295 and VA-288 in Area West of Richmond
The 43-mile-long section of I-64 from US-522 at Gum Spring in Goochland County
(excepting the I-95 overlap section which opened in 1958), through Henrico County
and the City of Richmond, to VA-249 at Bottoms Bridge in New Kent County, opened
to traffic in 5 sections from 1966 to 1968. These sections of I-64 were initially
built with 6 lanes: The 3.2-mile-long overlap with I-95, 3 miles from Glenside
Drive to I-95/I-195, and 7 miles from I-95 to VA-156 Airport Drive. The rest of
this I-64 section was initially built with 4 lanes. This section of I-64 contains
both interchanges with I-295, which were built later.
A major widening project on I-64 for 7 miles between Glenside Drive and 1/2 mile
west of I-295, added one lane each way in the median of the pre-existing 4-lane
highway to make it 6 lanes (3 each way), and the US-250 interchange at Short Pump
was upgraded by the addition of two loop ramps on the south side of the interchange,
and built a high-capacity 2-lane left-turning movement for traffic between westbound
US-250 and eastbound I-64 (the normal solution of adding a loop ramp for this
movement was impractical due to the S&K Menswear corporate headquarters and distribution
center that would have to be razed to make space for such a ramp upgrade). This
project was completed in 1990.
The 15.3-mile-long I-295 northeast quadrant in Henrico County from I-95 to I-64
and US-60 at Seven Pines was opened in 3 sections from July 2 to October 30, 1980.
The 9.6-mile-long I-295 northwest quadrant in Henrico County from I-95 to I-64
at Short Pump opened on February 2, 1981, and that was when the current I-64/I-295
Short Pump interchange was completed.
I-295 has 6 lanes on the northwest quadrant (I-95 north to I-64 at Short Pump),
8 lanes on the northeast quadrant (I-95 north to I-64 at Sandston), 6 lanes from
I-64 to VA-36 at Hopewell, and 4 lanes from VA-36 to I-95 south of Petersburg.
This is the original configuration and there have been no major widening projects
as of 2006.
Original Western
Route 288 Proposal
The western portion of Route VA-288 originally was proposed extending from today's
I-64/I-295 junction near Short Pump in western Henrico County, through Midlothian
in Chesterfield County, to the junction of Route 288 and Route VA-76 in Chesterfield
County, west of the City of Richmond. I-295 and Route 288 would have formed a
seamless Richmond Beltway, with that freeway junctioning I-64 near Short Pump
with a full cloverleaf interchange (4 loops and 4 outer ramps). The northerly
half of the movements of that interchange was built and opened to traffic in 1981,
along with the entire I-295 mainline pair of 3-lane roadways extending through
the interchange and temporarily ending about 100 yards south of I-64; with the
ultimate plan to complete the southerly half of the movements of that interchange
when Route 288 was extended to the south of I-64. Route 288 would have had a half-cloverleaf
interchange with US-250 Broad Street Road at Short Pump, with the ramps to the
south of US-250, providing full interchange movements between Route 288 and US-250.
After location studies in the late 1960s, this easterly Route 288 route location
was approved by the Virginia State Highway Commission in 1969, with a seamless
I-295/VA-288 Richmond Beltway configuration at Short Pump. This proposed location
for the western portion of Route 288 was abandoned by the Commonwealth Transportation
Board (former VSHC) in 1988, due to extensive later development along portions
of the route in Chesterfield and Henrico Counties (28 businesses along US-60 in
Midlothian would have been razed by the original location); that is when the present
western location of VA-288 was approved by the CTB, and this location passes through
the eastern corner of Powhatan County and the eastern portion of Goochland County,
interchanging I-64 about 1/2-mile west of the Goochland/Henrico County Line. A
4-lane arterial highway location was also approved by the CTB in 1989, the John
Rolfe Parkway, as a 3-mile-long highway extension from I-295 southward from I-64
to Gayton Road. About 1.2 mile of the John Rolfe Parkway has been built between
Gayton Road and Ridgefield Parkway, but most of the parkway remains unbuilt.
The John Rolfe Parkway connection to
the I-64/I-295 interchange, has been deleted from the Henrico County master plan,
as confirmed by VDOT engineers in a 2005 discussion, so the design of the current
I-64/I-295 Interchange Modification Project is configured with the understanding
that there will not be a southerly connection/extension to/from this interchange
and I-295. The future plan for the I-64/I-295 interchange is for it to remain
a 3-leg freeway-to-freeway interchange.
The newspaper Richmond Times-Dispatch had a couple articles in 2005
about official discussions by Henrico County about applying to the state for a
new local interchange to be built on I-64 about 1.5 mile west of I-295, and this
interchange would be with a northern 4-lane extension of Gayton Road. This interchange,
in conjunction with the existing I-64/US-250 interchange, would provide enough
local access in the Short Pump area to I-64 and I-295, to replace the need for
a John Rolfe Parkway connection to the I-64/I-295 interchange.
See Roads to the Future article Richmond Beltway (I-295 and VA-288) for a map of that facility as originally envisaged, and more historical details of the two highways.
Related Roads to the Future Articles
Interstate
64 in Virginia
Interstate
295 in Virginia
Richmond
Beltway (I-295 and VA-288)
Route VA-288 Construction - Western
Section
Credits
All photos by Scott Kozel.
Copyright © 2006-2009 by Scott Kozel. All rights reserved. Reproduction, reuse, or distribution without permission is prohibited.
By Scott M. Kozel,
Roads to the Future(Created 4-1-2006, last updated 5-1-2009)
